Micro-Grid Laboratory Status

  • Master plan presentation

    AIT recomandations:
    - Electrical capacity building laboratory
    - Data acquisition laboratory
    - Micro Grid Emulator (300 KVA)
  • 1st PMC Dispatch

    IRESEN : Master plan presentation
    IRESEN : Budget Breakdown presentation (Taking under consideration AIT's cost estimation (300 KVA Lab)
    PMC : KIER Micro-Grid Lab presentation (300 KVA laboratory)
  • PMC 2nd Dispatch

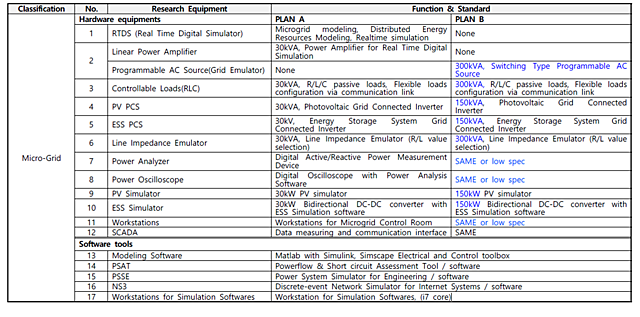

    PMC 2nd Dispatch
    PMC : Equipment proposal (Plan A :30 KVA laboratory due to budget limitation (Amplifier + Real Time Simulator); Plan B: 300 KVA capacity without amplifier and Real time simulator)
    IRESEN: Request budget breakdown
    IRESEN: Will provide equipment information, suppliers and cost estimation for Real Time simulator and Amplifier

  • Equipment list proposal sent by IRESEN

    Equipment list proposal sent by IRESEN

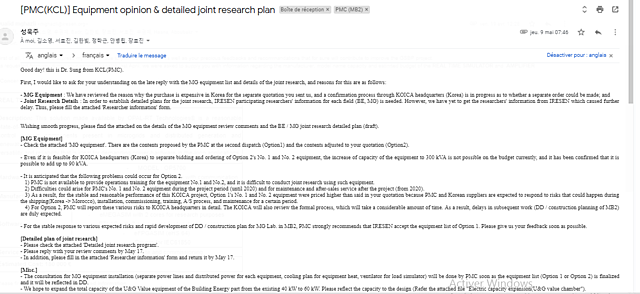

  • PMC response regarding our equipment list proposal

    PMC response regarding our equipment list proposal
    Option 1:Real Time Digital Simulator + Amplifier (30 KVA from Korean supplier) ----> Recommanded By PMC
    Option 2: Real Time Digital Simulator (OPAL) + Amplifier 30 KVA (SPS) + AC generator 90 KVA ------> PMC doesn't recommand this option because he claims he doesn't have the expertise to run joint research with european equipment

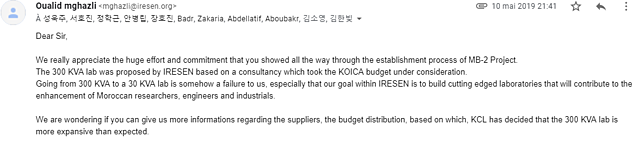

  • IRESEN's Response sent o PMC : Budget breakdown requested

    IRESEN's Response sent o PMC : Budget breakdown requested
    The 300 KVA lab was proposed by IRESEN based on a consultancy which took the KOICA budget under consideration. Going from 300 KVA to a 30 KVA lab is somehow a failure to us, especially that our goal within IRESEN is to build cutting edged laboratories that will contribute to the enhancement of Moroccan researchers, engineers and industrials.

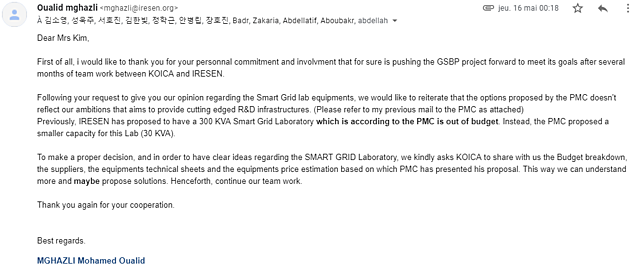

  • Response to Miss KIM and clarification of IRESEN's will to acquire cutting edge equipments

    Response to Miss KIM and clarification of IRESEN's will to acquire cutting edge equipments
